Menawethan – Build update June 2025

Structural Progress

The steel structure of the vessel is now fully complete, with all units successfully integrated, including the side door for the pallet hoist.

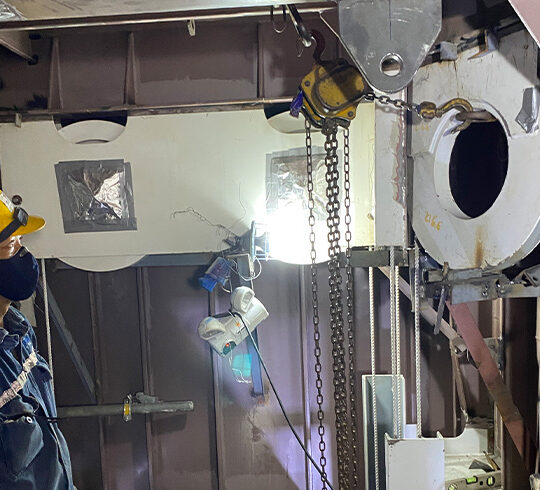

The pallet hoist itself has been erected and inspected by the manufacturer’s service engineer, with final welding work now underway to secure it in place.

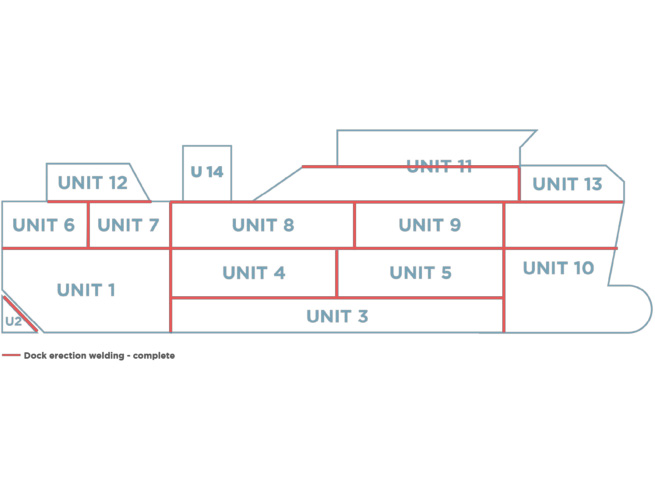

This illustration below shows where dock erection welding has been completed.

Mechanical Installation

The outer stern tubes have been fully installed, and installation work continues on the rudder carriers and bearings. The tunnel thrusters and associated tubes are fully integrated into the hull, marking another key milestone in the propulsion and manoeuvring systems.

Outfitting

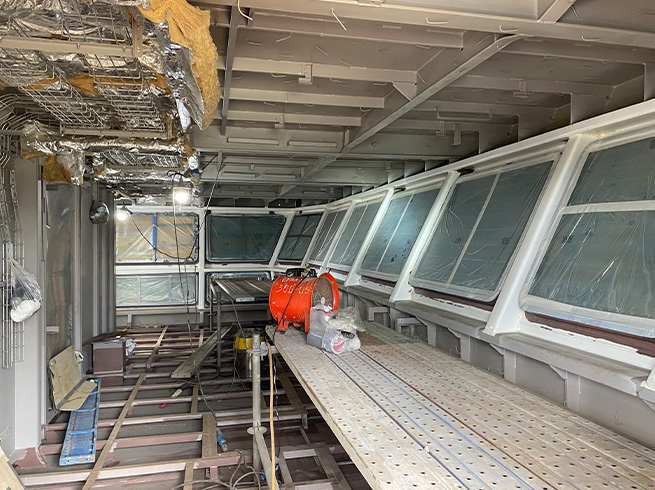

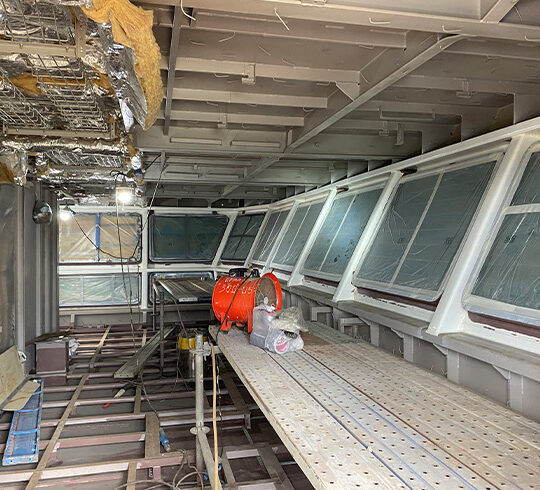

All windows and portholes have now been installed throughout the wheelhouse and accommodation areas, adding definition to the vessel’s superstructure.

Blasting and Painting

Blasting and painting across tanks, voids, and internal compartments is progressing steadily, with approximately 30% of the internal paintwork now complete. Various units are at different stages, from recently blasted and ready for coating, to fully coated and painted.

Ongoing Systems Work

Significant work is continuing across the vessel on the manufacture and installation of key systems, including piping, cable trays, penetrations, and ventilation ducting, which are critical to bringing all onboard systems online.

The pre-outfitting of the crew accommodation and the passenger lounge areas are also progressing well.
